Housing Program & Goals



OCII became the Successor Agency to the San Francisco Redevelopment Agency (“SFRA”) after SFRA was dissolved in 2012 pursuant to state law. As Successor Agency, OCII’s work activities are focused on enforceable obligations that have been approved by the State Department of Finance (“DOF”). OCII’s “Retained Housing Obligations” include ensuring the development of affordable housing in OCII’s approved Project Areas.

OCII directly carries out affordable housing development design review, entitling, underwriting and funding. In addition, OCII procures services from the Mayor’s Office of Housing and Community Development (MOHCD) through a Memorandum of Understanding for outreach and marketing for both inclusionary and OCII funded projects, implementing the Certificate of Preference program, assisting with the fiscal management and disbursement of OCII’s funds, some construction monitoring, and other ancillary tasks as needed. Upon completion of the projects, OCII transfers the affordable housing assets such as land, funding agreements, ground leases, and affordability restrictions for each completed project to MOHCD, which is then responsible for all asset management responsibilities.

Tables 4A-G (see pages 11-18) reflect all OCII housing obligations and production goals as of June 30, 2023.

Of OCII’s 21,927 planned total housing units, 7,104 (32% of the total) will be affordable. As of the end of FY 22-23, a total of 9,239 housing units (42% of the total goal) have been completed. Of these completed units, 2,752 are affordable units and 6,487 are market rate units. The total affordable units comprise both 100% OCII funded affordable projects and inclusionary units in market rate projects.

More information on OCII’s Project Areas can be found on OCII’s website: OCII Projects Overview

FY 2022-2023 Annual Housing Report

Housing Types

Rental housing in OCII’s projects include Family Rental (generally a mix of bedroom sizes, with no other population restrictions), Senior Rental (for those 62 years or older), and Supportive Rental (for formerly homeless households or other special needs). Rental units in 100% affordable developments typically offer services programming along with affordable rents. Homeownership units are typically condos in multi-family buildings or towers. Affordable homeownership units are offered to first time homebuyers through a limited equity program.

Table 3 reflects that 58% of completed units are for family rental, 2% are for senior rental, and 36% of completed units are for homeownership.

Hunters Point Shipyard Phase I

For Hunters Point Shipyard Phase I (HPSY Phase I), the total housing production goal at full build-out is 1,428 units, of which 29% (or 407 units) will be affordable. HPSY Phase I is divided into two areas, the “Hilltop”, where all the housing development to date has occurred, and the “Hillside”, which has not yet started development. Table 4C (see page 13) shows that in HPSY Phase I, housing production at the end of FY 22-23 was 35% complete with 505 units completed. Of those completed units, 102 are affordable housing units including 43 homeownership units within market rate buildings on multiple blocks within the Hilltop, and another 59 inclusionary rental units in a 100% affordable project.

HPSY Phase I is not a part of the Navy’s retesting efforts described below and has been confirmed by the U.S. Environmental Protection Agency to be safe for people to live and work there.

In July through November of 2018, in response to public concerns and at the request of the City and U.S. House of Representatives Speaker, Nancy Pelosi, the California Department of Public Health (“CDPH”) performed a phased-approach radiological survey to assess the health and safety of the public and the environment at Parcel A of the Shipyard.

CDPH completed a Final Report for Hunters Point Shipyard Parcel A-1 on February 5, 2019 followed by a Final Report for Parcel A-2 on April 24, 2019. Both CDPH reports concluded that no residents, workers, or visitors are being exposed to radiological health and safety hazards at Parcel A.

To address continued concerns and questions from the community regarding testing conducted at the Shipyard, Mayor Breed, then-City Attorney Herrera, and Supervisor Walton asked experts from UC San Francisco and UC Berkeley to conduct an impartial analysis of CDPH’s procedures for Parcel A. Their report concluded that CDPH’s health and safety scan on Parcel A was appropriate as a health and safety survey.

Out of an abundance of caution, OCII worked with the developers to establish a scope of additional radiological soil testing at OCII’s stand-alone affordable sites at Blocks 52 & 54, and Block 56 to be conducted along with the standard Phase II environmental testing.

In 2021, OCII and the developers’ environmental consultant, Langan Engineering and Environmental Services, collected soil borings from Blocks 52, 54 and 56 for that testing. These radiological testing results indicate no contamination and no risk to construction workers, the public or future residents.

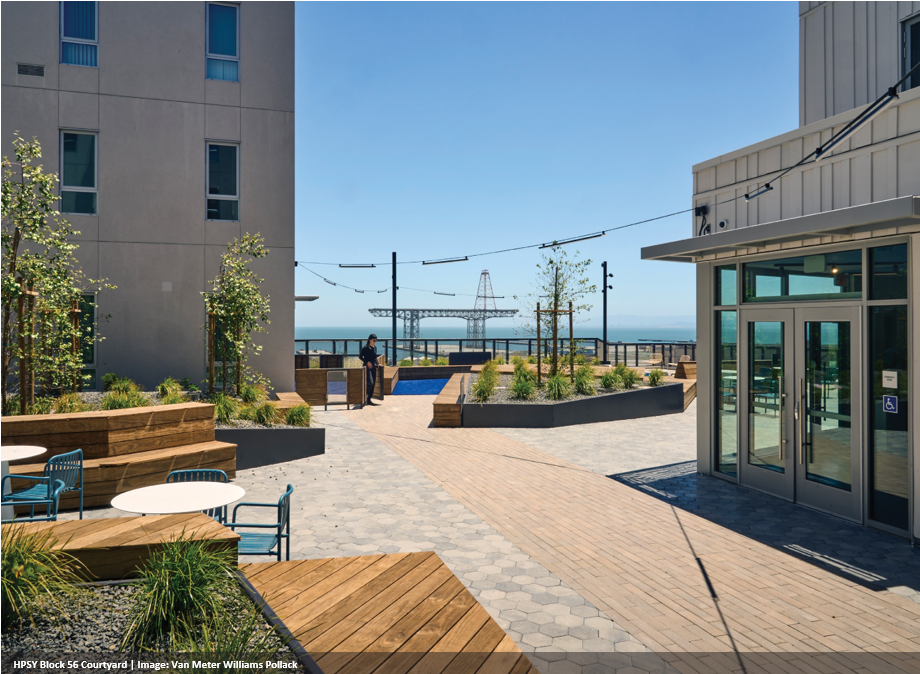

Construction began on Blocks 52 and 54 and Block 56 in FY 22-23. When completed in 2025, these 100% affordable projects will add a total of 185 units (including 2 managers’ units) ranging in affordability from 30% to 50% AMI to the Hilltop.

Hunters Point Shipyard Phase II/Candlestick Point

For Hunters Point Shipyard Phase II/Candlestick Point (HPSY Phase II/CP), the total housing production goal at full build-out is 10,672 units, of which approximately 31% will be affordable. The affordable housing program in HPSY Phase II/CP is unique in that it includes the broadest range of affordability, providing typical affordable units serving households ranging from very low-income households up to those at 120% of AMI, as well as “workforce” housing that will serve slightly higher incomes of 140% to 160% of AMI. Table 4D shows that in HPSY Phase II/CP, the housing production at the end of FY20-21 was 3% complete. Those completed units are all part of the new housing in Candlestick Point for the HOPE SF revitalization of the Alice Griffith public housing development. The three market rate units represent the onsite property managers’ units, which are not income restricted.

The land in HPSY Phase II is an environmental “Superfund” site that requires clean-up by the Navy. Portions of HPSY Phase II are the subject of an investigation regarding the testing that was performed after the Navy had completed certain clean up and remediation activities. No construction is currently occurring on any of the HPSY Phase II parcels, and OCII will not accept any land or begin any development on HPSY Phase II until each parcel is tested and determined by regulatory agencies to be safe.

For Hunters Point Shipyard Phase II/Candlestick Point (HPSY Phase II/CP), the total housing production goal at full build-out is 10,672 units, of which approximately 32% or 3,363 units will be affordable. The affordable housing program in HPSY Phase II/ CP is unique in that it includes the broadest range of affordability, providing typical affordable units serving households ranging from very low-income households up to those at 120% of AMI, as well as “workforce” housing that will serve slightly higher incomes of 140% to 160% of AMI.

Table 4D (see page 14) shows that in HPSY Phase II/CP housing production at the end of FY 22-23 was 3% complete. Those completed units are all part of the new housing in Candlestick Point for the HOPE SF revitalization of the Alice Griffith public housing development. The three market rate units represent the onsite property managers’ units, which are not income restricted.

The land in HPSY Phase II is in an environmental “Superfund” site still owned by the Navy and requires clean-up by the Navy. Portions of HPSY Phase II are the subject of an investigation regarding the testing that was performed after the Navy had completed certain clean up and remediation activities. No construction is currently occurring on any of the HPSY Phase II parcels, and OCII will not accept any land or begin any development on HPSY Phase II until each parcel is tested and determined by regulatory agencies to be safe.

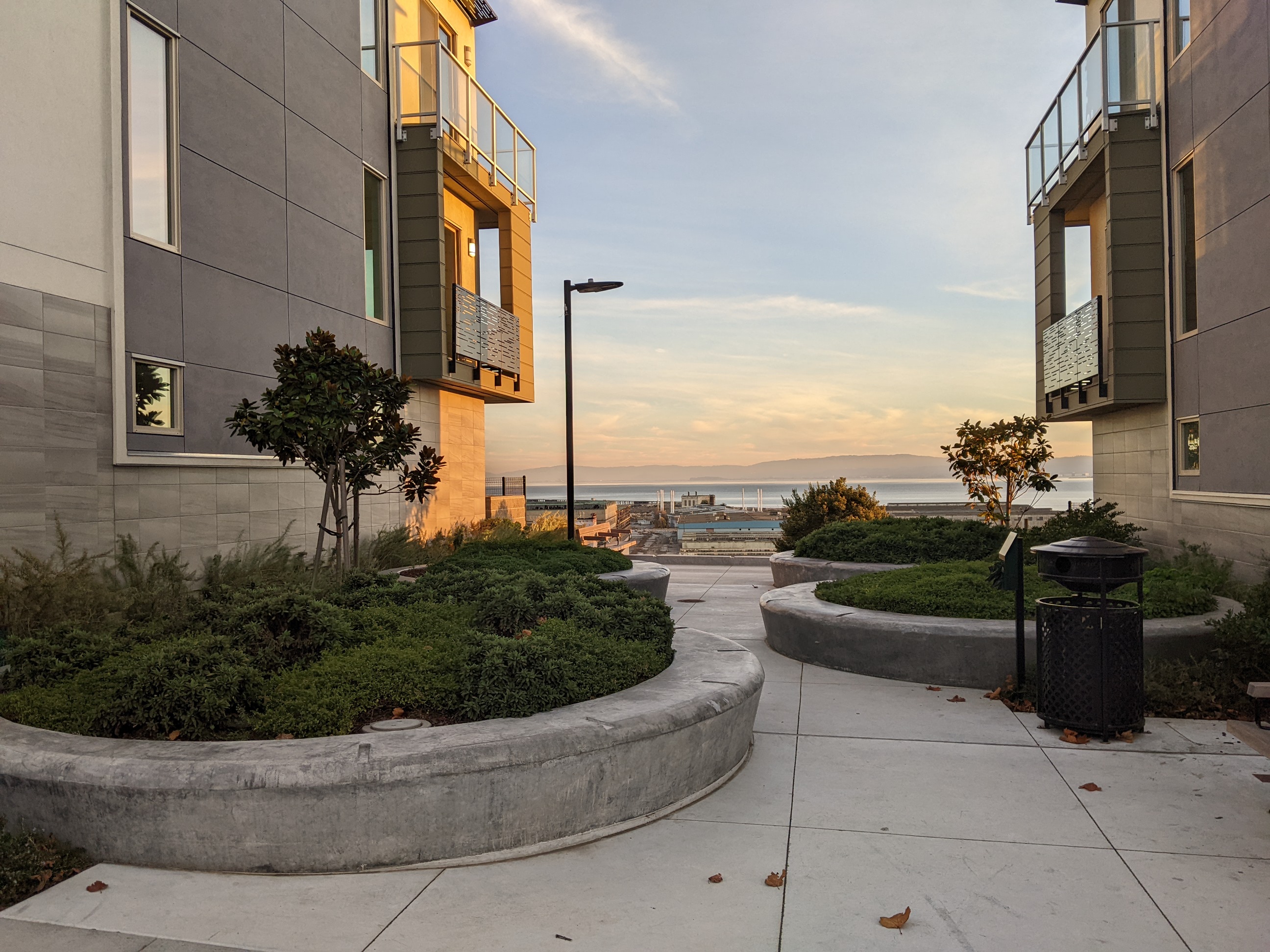

Hunters Point Shipyard Phase 1, Pocket Park II Image: @OCII

Mission Bay North and South

Together, the Mission Bay North (MBN) and South (MBS) total housing production goal at full build-out is 6,535 units, of which 29% (or 1,908 units) will be affordable. Planned housing construction in the two Project Areas combined was 95% complete at the end of FY 22-23 for a total of 6,201 units. Table 4E (see page 15) reflects housing completions in MBN, which was fully complete in FY 16-17, providing 2,266 market rate units and 698 affordable units (24% of the total units). Table 4F (see page 16) shows that in MBS, the Project Area was 91% complete at the end of FY 22-23, with 3,237 units completed out of 3,571. As of FY 22-23, market rate units were 99% complete, and 74% of the OCII affordable units were completed. At full build-out, the housing in MBS will be 34% affordable.


OCII is exploring approaches that will increase the density of the remaining 2 affordable housing parcels in MBS. Increasing density will require local approvals, including an amendment of the redevelopment plan and associated governing documents.

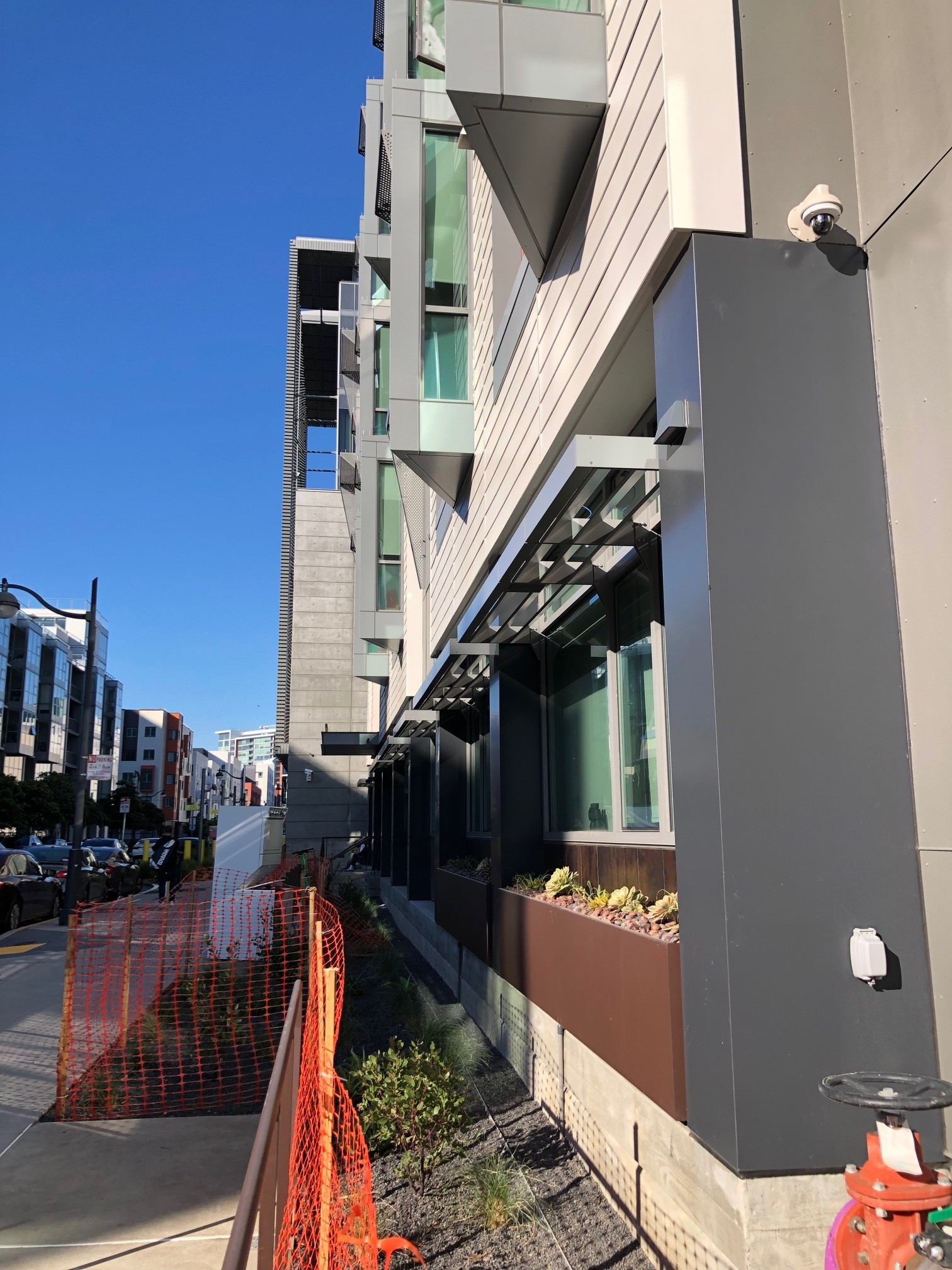

MBS Block 9, 410 China Basin Street Image @OCII

Transbay

Overall, 35% of all new housing in Zones 1 and 2 combined must be affordable. OCII must achieve this goal by the expiration of the Transbay Redevelopment Plan in 2035.

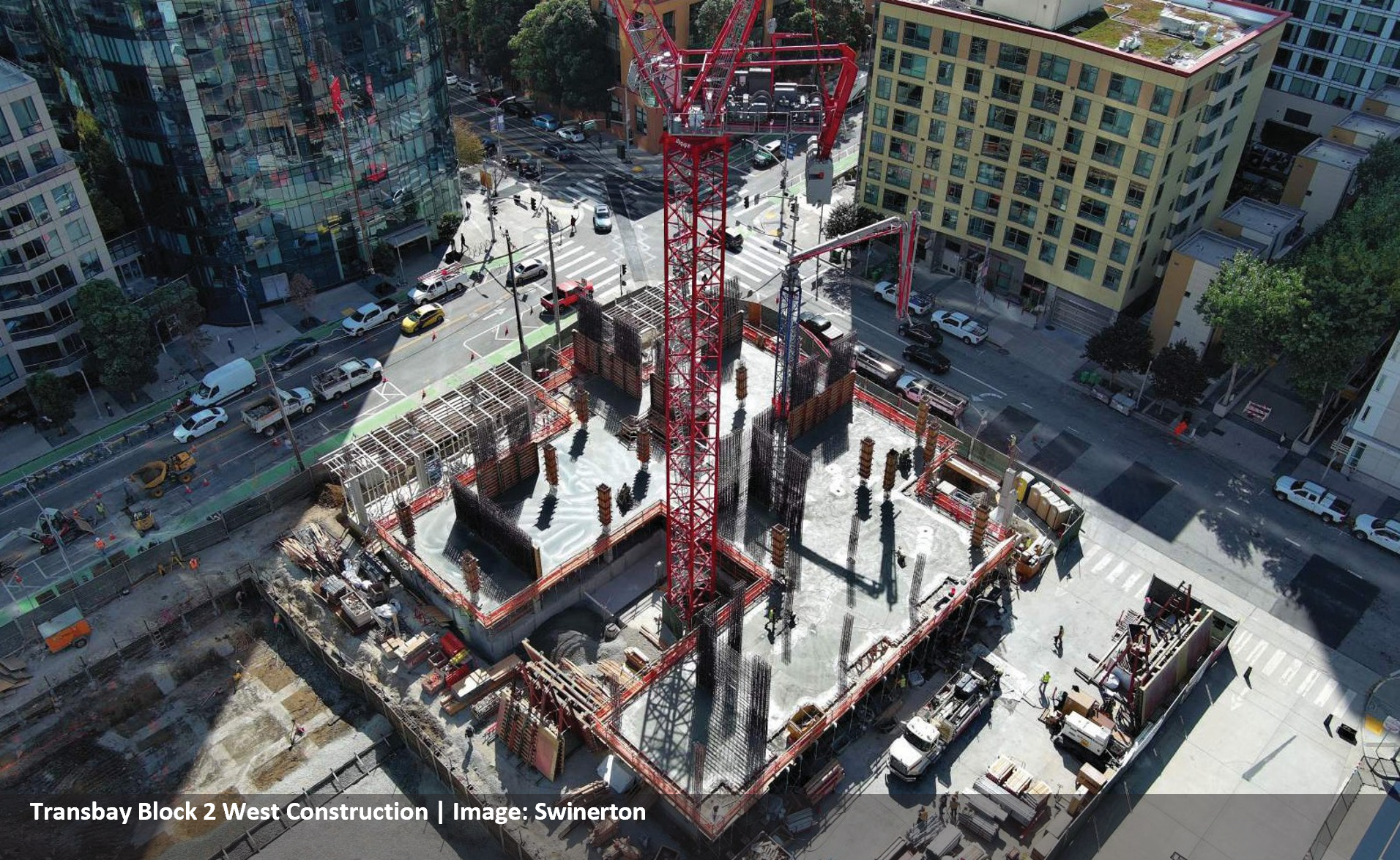

In Transbay Zone 1 for which OCII has land use and zoning jurisdiction, the total housing production goal at full build-out is 3,292 units, of which 43% (or 1,438 units) will be affordable.

Table 4G.1 (see page 17) shows that in Transbay Zone 1, housing production at the end of FY 22- 23 was 68% complete with 2,196 units. Of these completed units in Zone 1, 463 were affordable units in OCII funded, 100% affordable housing developments.

Transbay Zone 2 is under the jurisdiction of the City’s Planning Department, and not a subject of this report. However, Table 4G.2 (see page 18) is presented to show Transbay Zones 1 and 2 combined, and that given the high percentage of affordability in Zone 1, OCII is on track to meet the 35% goal.

Table 3: Total Units by Housing Type

TYPECompleted% Completed Units
by Housing Type
Affordable Units
Completed
In ConstructionPredevelopmentPreliminary PlanningFuture DevelopmentGrand Total
TABLE 3. STATUS OF TOTAL UNITS BY HOUSING TYPE AS OF JUNE 30, 2023
Family Rental5,37658%1,8771851,220575 7,356
Senior Rental1402%140 15123680607
Supportive Rental3804%378    380
Homeownership3,34336%3572251,53621 5,125
TBD 0%   5797,8808,459
TOTAL9,239100%2,7524102,9071,4117,96021,927

Table 4: Housing Production Goals and Status by Project Area

 Total UnitsMarket RateInclusionary AffordableOCII AffordableTotal Affordable
TABLE 4. HOUSING PRODUCTION GOALS AND STATUS BY PROJECT AREA
TABLE 4A. HOUSING STATUS FOR ALL AREAS, AS OF JUNE 30, 2023
Completed as of 6/30/239,2396,4876512,1012,752
In Construction410719330339
Predevelopment2,9071,7924536621,115
Preliminary Planning1,411861162388550
Future Development7,9605,6011,5068532,359
TOTAL21,92714,8122,7814,3347,115
% AFFORDABLE OF TOTAL HOUSING GOAL32%
AFFORDABLE UNITS AS % OF TOTAL COMPLETED30%
% COMPLETE, ALL UNITS42%

*OCII affordable does not include manager’s units

Table 4. HOUSING PRODUCTION GOALS AND STATUS BY ENFORCEABLE OBLIGATION

 Hunters Point Shipyard Phase IHunters Point Shipyard Phase II & Candlestick PointMission Bay North & SouthTransbayTotal
TABLE 4. HOUSING PRODUCTION GOALS AND STATUS BY PROJECT AREA
TABLE 4B. AFFORDABLE AND MARKET RATE HOUSING STATUS BY ENFORCEABLE OBLIGATION, AS OF JUNE 30, 2023
Completed5053376,2012,1969,239
In Construction262 148 410
Predevelopment6281,263 1,0162,907
Preliminary Planning 1,225186 1,411
Future Development337,847 807,960
TOTAL1,42810,6726,5353,29221,927
% COMPLETE35%3%95%67%42%



 Total UnitsMarket RateInclusionary
Affordable
OCII
Affordable
Total
Affordable
TABLE 4. HOUSING PRODUCTION GOALS AND STATUS BY PROJECT AREA
TABLE 4C. HUNTERS POINT SHIPYARD PHASE I STATUS, AS OF JUNE 30, 2023
Completed505403102 102
In Construction262719182191
Predevelopment62854880 80
Preliminary Planning
Future Development33  3333
TOTAL1,4281,022191215406
% COMPLETE35%39%53%0%25%
AT FINAL BUILD OUT, % AFFORDABLE OF TOTAL UNITS: 29%

*OCII affordable does not include manager’s units



 Total UnitsMarket RateInclusionary
Affordable
OCII
Affordable
Total
Affordable
TABLE 4. HOUSING PRODUCTION GOALS AND STATUS BY PROJECT AREA
TABLE 4D. HUNTERS POINT SHIPYARD PHASE II / CANDLESTICK POINT STATUS, AS OF JUNE 30, 2023
Completed3374 333333
In Construction
Predevelopment1,26386667330397
Preliminary Planning1,225839162224386
Future Development7,8475,6001,5067412,247
TOTAL10,6727,3091,7351,6283,363
% COMPLETE3%0%0%21%10%
AT FINAL BUILD OUT, % AFFORDABLE OF TOTAL UNITS: 32%

*OCII affordable does not include manager’s units



 Total UnitsMarket RateInclusionary
Affordable
OCII
Affordable
Total
Affordable
TABLE 4. HOUSING PRODUCTION GOALS AND STATUS BY PROJECT AREA
TABLE 4E. MISSION BAY NORTH STATUS, AS OF JUNE 30, 2023
Completed2,9642,266291407698
In Construction
Predevelopment
Preliminary Planning
Future Development
TOTAL2,9642,266291407698
% COMPLETE100%100%100%100%100%
AT FINAL BUILD OUT, % AFFORDABLE OF TOTAL UNITS: 24%

*OCII affordable does not include manager’s units



 Total UnitsMarket RateInclusionary
Affordable
OCII
Affordable
Total
Affordable
TABLE 4. HOUSING PRODUCTION GOALS AND STATUS BY PROJECT AREA
TABLE 4F. MISSION BAY SOUTH STATUS, AS OF JUNE 30, 2023
Completed3,2372,339 898898
In Construction1481 148148
Predevelopment
Preliminary Planning18622 164164
Future Development
TOTAL3,5712,361 1,2101,210
% COMPLETE91%99% 74%74%
AT FINAL BUILD OUT, % AFFORDABLE OF TOTAL UNITS: 34%

*OCII affordable does not include manager’s units



 Total UnitsMarket RateInclusionary
Affordable
OCII
Affordable
Total
Affordable
TABLE 4. HOUSING PRODUCTION GOALS AND STATUS BY PROJECT AREA
TABLE 4G.1 TRANSBAY STATUS, ZONE 1 ONLY, AS OF JUNE 30, 2023
Completed2,1961,475258463721
In Construction
Predevelopment1,016378306332626
Preliminary Planning
Future Development801 7979
TOTAL3,2921,8545648741,426
% COMPLETE 67%80%46%53%51%

AT FINAL BUILD OUT OF ZONE 1, % AFFORDABLE OF TOTAL UNITS: 44%

AT FINAL BUILD OUT OF ZONE 1, INCLUDING ESTIMATED ZONE 2 UNITS (STATE LAW REQUIREMENT) % AFFORDABLE: 36%

*OCII affordable does not include manager’s units



 Total UnitsMarket RateInclusionary
Affordable
OCII
Affordable
Total
Affordable
TABLE 4. HOUSING PRODUCTION GOALS AND STATUS BY PROJECT AREA
TABLE 4G.2 TRANSBAY STATUS, ZONES 1 AND 2 COMBINED, AS OF JUNE 30, 2023
Completed2,6661,885318463781
In Construction
Predevelopment1,181543306332638
Preliminary Planning
Future Development801 7979
TOTAL3,9272,4296248741,498
% COMPLETE 68%78%51%53%52%
AT FINAL BUILD OUT, % AFFORDABLE OF TOTAL UNITS: 35%

*OCII affordable does not include manager’s units
**Zone 2, although not in OCII’S jurisdiction, is included above to reflect the 35% affordable requirement in Zones 1 and 2 combined
