Housing Accomplishments

Housing Completions & Project Summaries

In FY 24-25, construction of 410 units in four projects were completed. These include two affordable family rental buildings and one market rate with inclusionary homeownership project and one 100% affordable homeownership project in Mission Bay South. There are project specific details in subsequent pages and in Chapter 6, Appendix.

Table 5: Housing Completions

Project AreaProject NameProject TypeHousing TypeTotal
Units
Total Aff.
Units*
TABLE 5. HOUSING COMPLETIONS

HPSY Phase I

Block 52

Market Rate w/ Inclusionary

Homewonership

77

9

HPSY Phase I

Blocks 52 & 54

100% Affordable

Family Rental

112

110

HPSY Phase I

Block 56

100% Affordable

Family Rental

73

72

Mission Bay South

Block 9

100% Affordable

Homeownership

148

148

TOTAL

410

339

*OCII affordable does not include manager’s units

HPS Block 52

PROJECT NAME

Hunters Point Shipyard Block 52: 52 Kirkwood Avenue

PROJECT AREA

HPSY Phase 1

SPONSOR/DEVELOPER

Lennar

ARCHITECT

LPAS

PROJECT/HOUSING TYPE

Market Rate w/ Inclusionary/Homeownership

TOTAL/AFFORDABLE UNITS

77/9

CONSTRUCTION COMPLETED

June 15, 2025

TOTAL OCII FUNDING

$0

AFFORDABLE UNITS

80% AMI
52 Kirkwood Avenue

PROJECT NAME

Hunters Point Shipyard Blocks 52 and 54: 351 and 151 Friedell St.

PROJECT AREA

HPSY Phase 1

SPONSOR/DEVELOPER

Jonathan Rose Companies / Bayview Hunters Point Multipurpose Senior Services

ARCHITECT

Mithun

PROJECT/HOUSING TYPE

100% Affordable / Family Rental

TOTAL/AFFORDABLE UNITS

112/110

CONSTRUCTION COMPLETED

May 15, 2025

TOTAL OCII FUNDING

$61,518,208

AFFORDABLE UNITS

30-50% AMI

H"SY Block 56 | Image: Van Meter Williams PollackHPSY Block 52-54 | Jasmine Kuo/Jonathan Rose
MBS Block 9A |Tom E. Brown (Bugsby)

PROJECT NAME

Hunters Point Shipyard Block 56: 275 Coleman St.

PROJECT AREA

HPSY Phase 1

SPONSOR/DEVELOPER

Mercy Housing California / San Francisco Housing Development Corporation

ARCHITECT

Van Meter Williams Pollack

PROJECT/HOUSING TYPE

100% Affordable / Family Rental

TOTAL/AFFORDABLE UNITS

73/72

CONSTRUCTION COMPLETED

April 28, 2025

TOTAL OCII FUNDING

$34,813,441

AFFORDABLE UNITS

50%
HPSY Block 56: 275 Coleman St.

PROJECT NAME

Mission Bay South Block 9A: 400 China Basin St.

PROJECT AREA

Mission Bay South

SPONSOR/DEVELOPER

Michael Simmons Property Development; Curtis Development; Young Community Developers

ARCHITECT

Mithun / Y.A. Studio

PROJECT/HOUSING TYPE

100% Affordable Homeownership

TOTAL/AFFORDABLE UNITS

148

CONSTRUCTION COMPLETED

2025

TOTAL OCII FUNDING

$83,184,522

AFFORDABLE UNITS

110% and below

Table 6: Housing in Construction

During FY 24-25, construction of units in two projects continued. In Transbay, two affordable rental projects, one serving families and one serving seniors.

See Table 6 for a summary of these projects. There are project-specific details on the following pages and in Chapter 6, Appendix.

Project AreaProject NameProject TypeHousing TypeTotal
Units
Total Aff.
Units*
TABLE 6. HOUSING IN CONSTRUCTION
TransbayBlock 2 West100% AffordableSenior Rental and Permanent Supportive Housing155150
TransbayBlock 2 East100% AffordableSenior Rentala nd Permanent Supportive Housing184182
TOTAL

335

332

*OCII affordable does not include manager's units

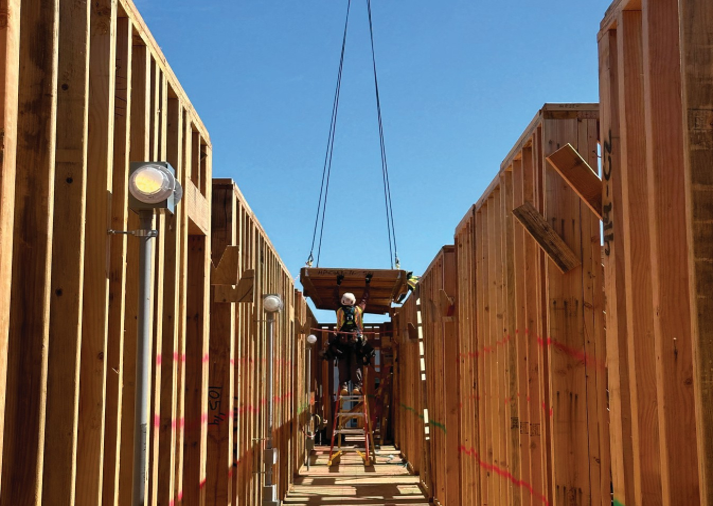

Construction Photo

Hunters Point Shipyard Blocks 52 & 54: 351 & 151 Friedell St.

PROJECT AREA

HPSY Phase 1

SPONSOR/DEVELOPER

Jonathan Rose Companies/Bayview Hunters Point Multipurpose Senior Services

ARCHITECT

Mithun

PROJECT/HOUSING TYPE

100% Affordable/Family Rental

TOTAL/AFFORDABLE UNITS

112/110

CONSTRUCTION COMPLETED

June 2023

TOTAL OCII FUNDING

$61,518,208

AFFORDABLE UNITS

30-50%

Hunters Point Shipyard Block 56: 11 Innes Ct.

PROJECT AREA

HPSY Phase 1

SPONSOR/DEVELOPER

Jonathan Rose Companies/Bayview Hunters Point Multipurpose Senior Services

ARCHITECT

Mithun

PROJECT/HOUSING TYPE

100% Affordable/Family Rental

TOTAL/AFFORDABLE UNITS

112/110

CONSTRUCTION COMPLETED

June 2023

TOTAL OCII FUNDING

$61,518,208

AFFORDABLE UNITS

30-50%
Hunters Point Shipyard Block 56: 11 Innes Ct.

Mission Bay South Block 9A: 400 China Basin St.

PROJECT AREA

Mission Bay South Block 9A: 400 China Basin St.

SPONSOR/DEVELOPER

Michael Simmons Property Development; Curtis Development; Young Community Developers

ARCHITECT

Mithun/Studio VARA

PROJECT/HOUSING TYPE

100% Affordable Homeowner

TOTAL/AFFORDABLE UNITS

148

CONSTRUCTION COMPLETED

July 2022

TOTAL OCII FUNDING

$83,184,522

AFFORDABLE UNITS

110% and below

Mission Bay South Block 9A, 400 China Basin Street, Image:@Mithun
MBS Block 9A

Housing in Construction & Project Summaries

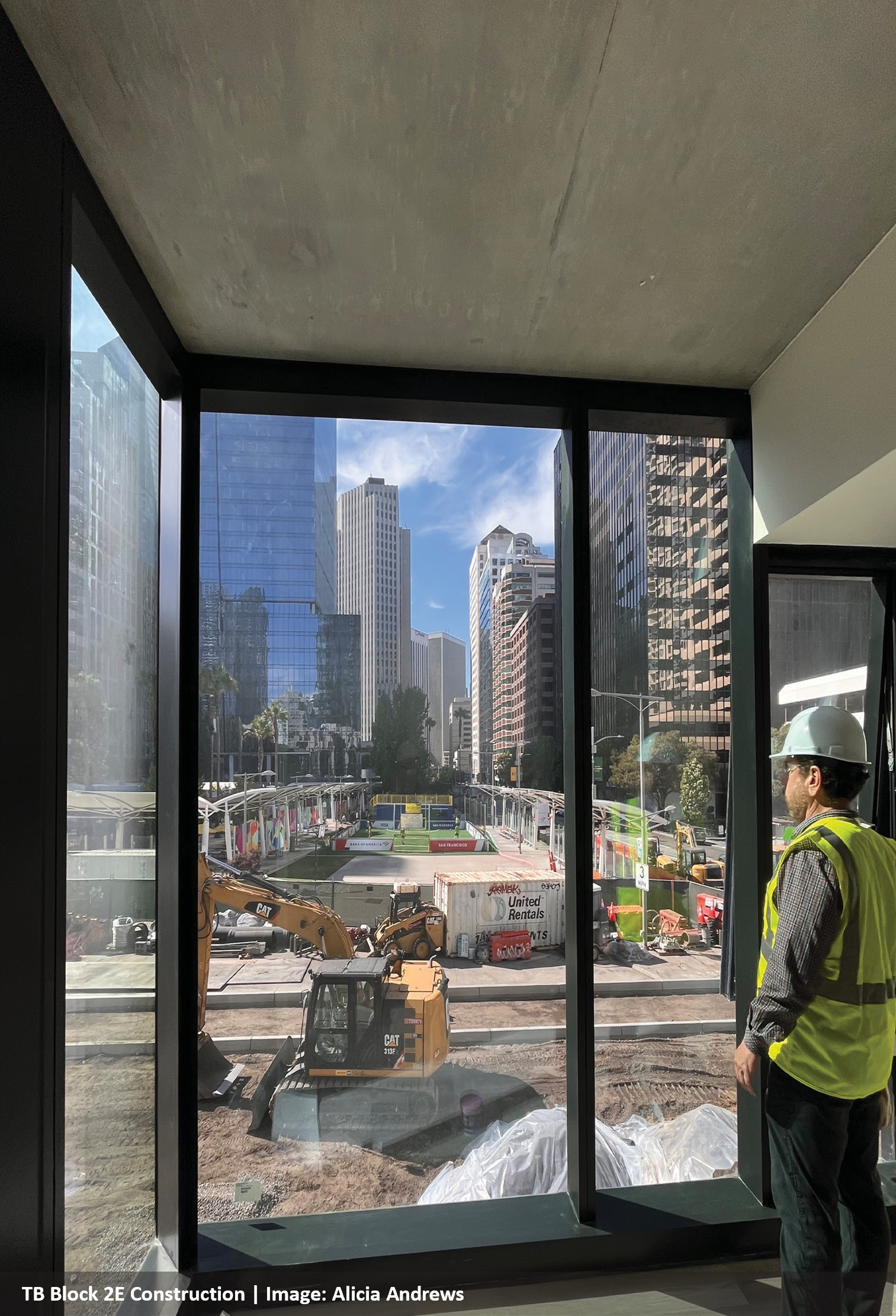

TB Block 2E Construction Image: Alicia AndrewsImage: Mithun

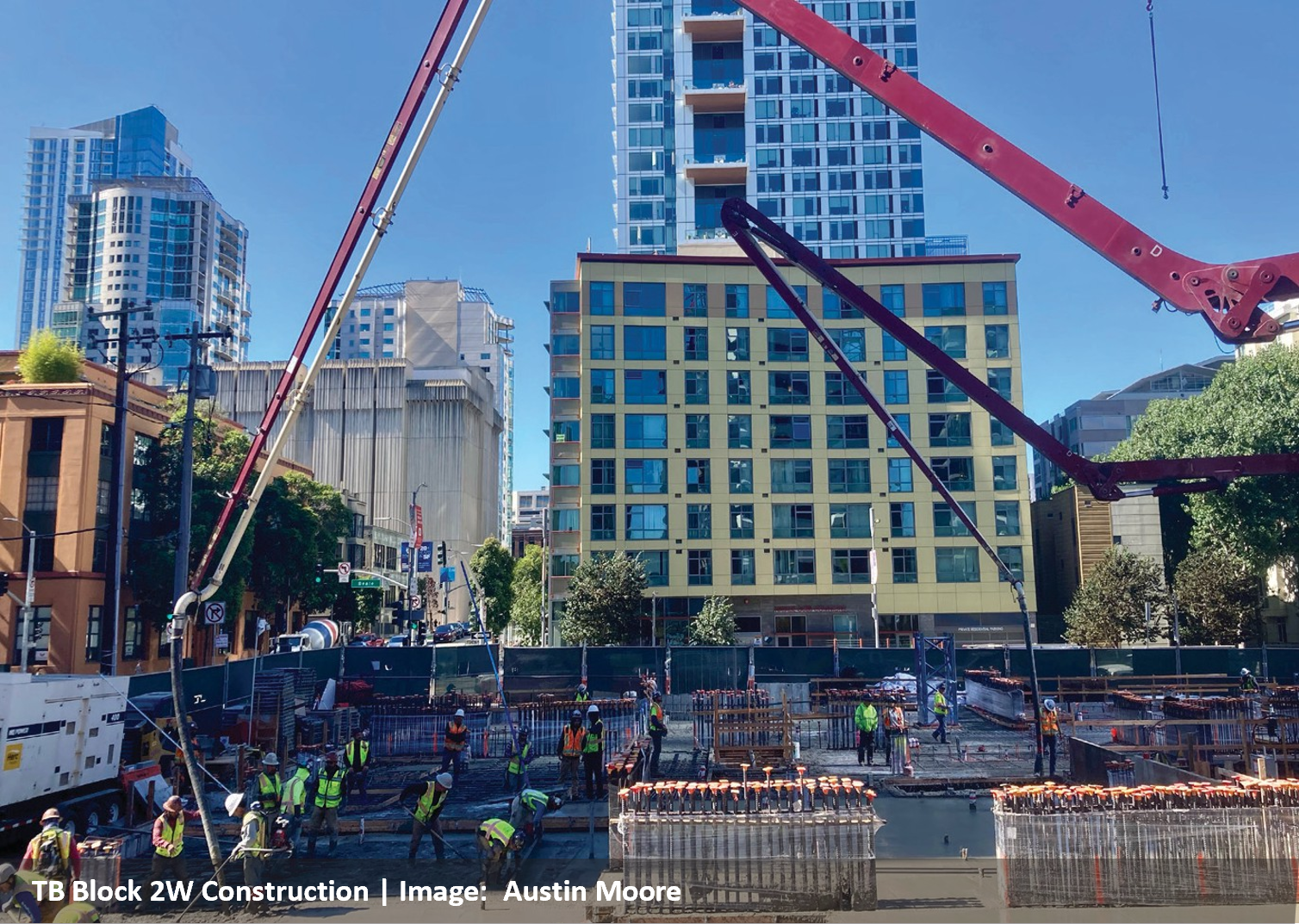

TB Block 2W Construction Image: Austin Moore

Marketing Accomplishments

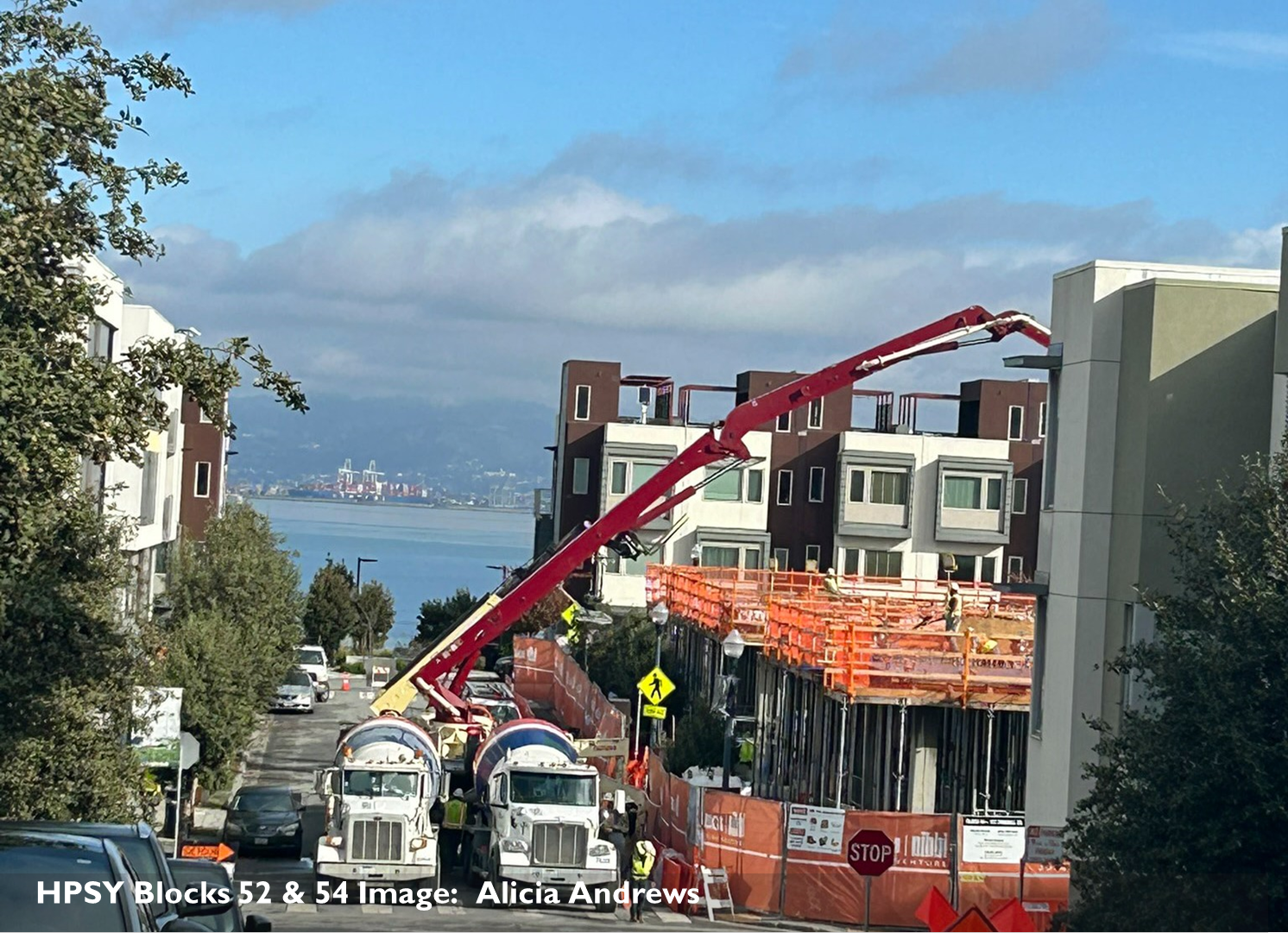

Early outreach continued in FY 24-25 for two affordable housing projects under construction: Transbay Block 2E and W. Blocks 52 and 54 and Block 56 in HSPY Phase I began marketing and leasing. Block 9a in MBS began to sell units.

Developers implemented Early Outreach Plans and began COP holder marketing, application readiness, leasing and sales activities. Early Outreach Plans describe the developers' partnerships with housing counseling agencies, and establish timeframes for outreach to and workshops for COP holders, in preparation for these upcoming rental and home ownership opportunities.

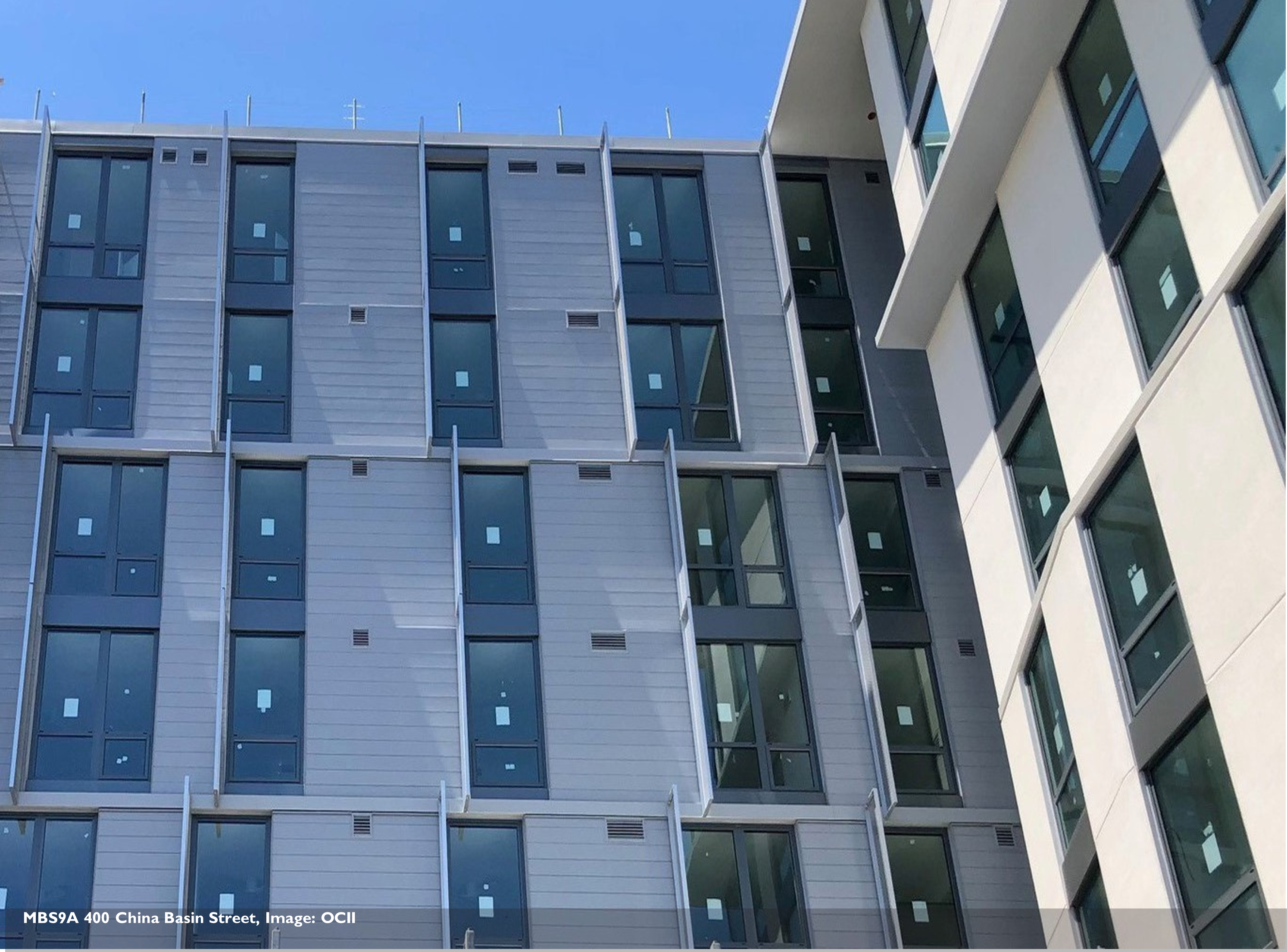

MBS 9A 400 China Basin Street

HPSY Block 52-54 Oscar James Courtyard | Image: Jasmine Kuo
